What "Turn-Key" Means on a Conveyor System
Turn-key is a delivery model, not a product. One provider takes responsibility for every phase needed to bring the project into operation. The provider then hands it over ready to run. So the buyer has a single point of responsibility instead of a list of suppliers. This delivery model is what the word turn-key means on a construction or industrial project. Turn-key is how Remcon works.
On a conveyor system, the scope covers four things: design, fabrication, shipping, and installation. We lay out the line, engineer the equipment, and write the control logic. We build the steel, hire the haulers, and design the loads. We send our own crew to erect the line in your plant.
Turn-key does not mean that every piece is welded in Airway Heights. Remcon's specialty is conveyors and their related products. If a line needs a shredder, a walking floor, a modular roller section, or a disc screen, we buy that machine. We buy it from the manufacturer that builds it best. We then integrate it into the conveyor system. The equipment in a turn-key line comes from more than one place. The accountability does not.
What a Complete System Includes

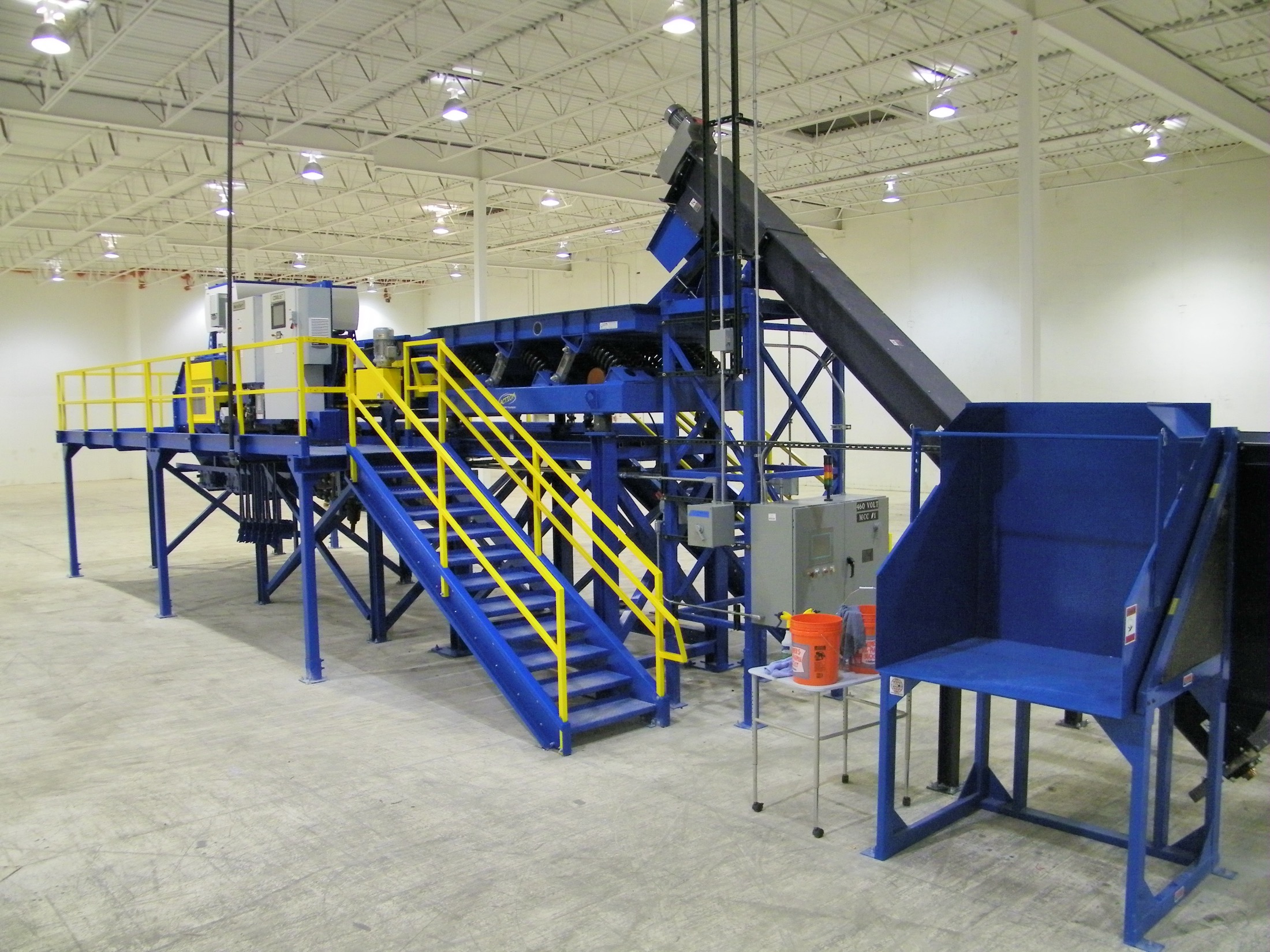

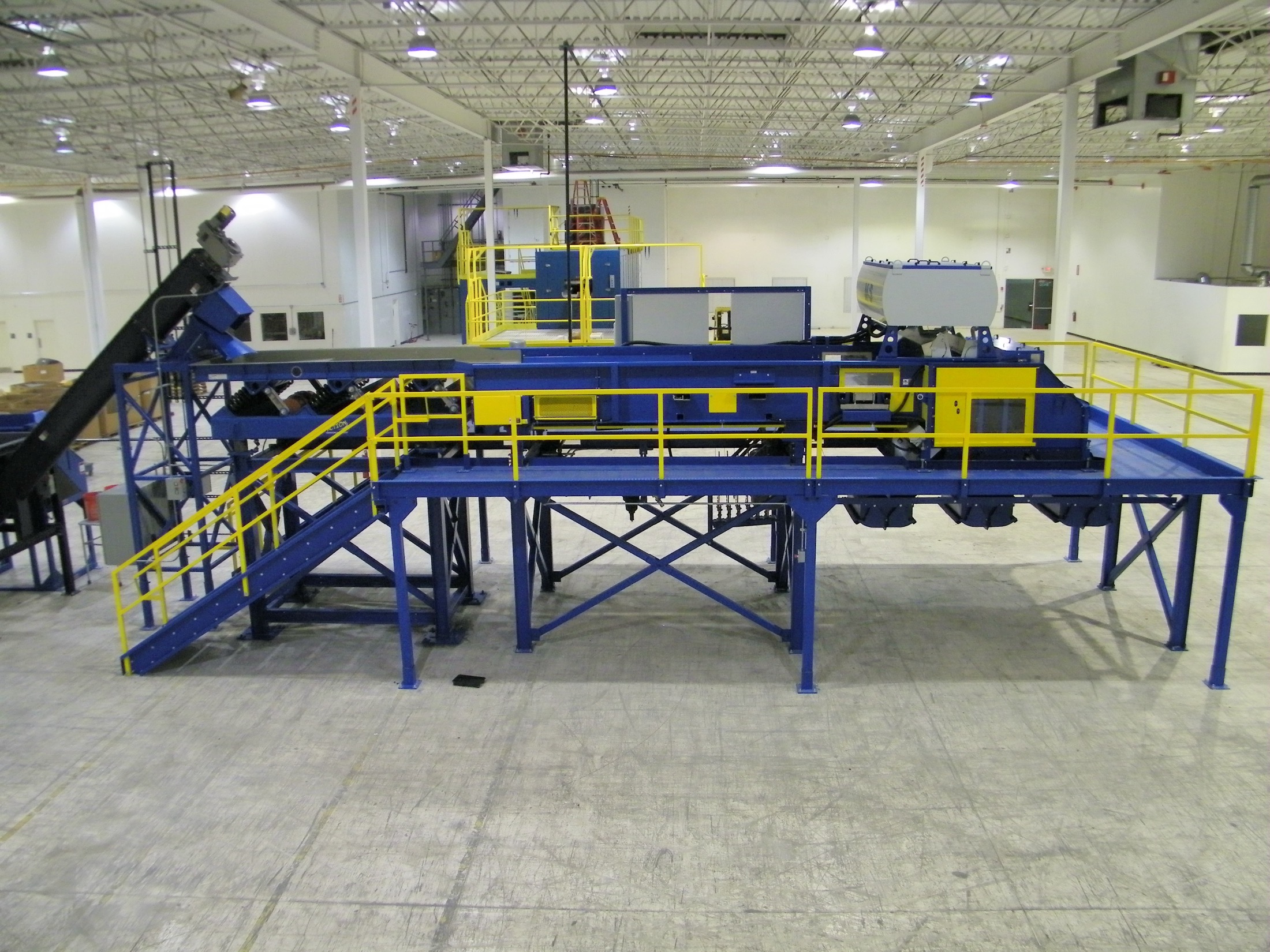

If you ask for a conveyor system, much of what arrives is not conveyor. A complete Remcon line has five parts.
- Conveyors: the part of the plant that moves material. The types are infeed and sort line feed runs, sorting conveyors, transfers, shuttles, and baler feed. Conveyors come in slider bed, chain, roller chain belt, troughing idler, and elbow-up construction. Belt widths range from 12" to 72".
- Sorting & separation: trommels, disc screens, vibratory screens, eddy current separators, overhead magnets, and magnetic head pulleys. The category also includes the high-speed conveyors and containment hoods that optical sorting equipment needs.
- Platforms & catwalks: sort platforms, maintenance catwalks, guardrail, stairs, and ladders. Guardrail is not decoration. OSHA's general industry rule puts the top rail 42" above the walking surface, plus or minus 3". The rule also requires the guardrail to withstand a force of 200 lb applied downward or outward within 2" of the top edge.
- Bins, bunkers & hoppers: surge and storage. The category includes bunker walls, storage hoppers, live floor bins, and self-emptying bins with take-away conveyors.
- Everything between them: support structure, chutework and transitions, and the electrical controls.
That last item is underestimated. Chutework carries material out of one manufacturer's machine and into the next. Chutework is not in anyone's catalog and is drawn for the specific pair of machines that it sits between. Support structure has to hold equipment at the working heights that the layout needs. The support structure also has to leave room for a forklift to pass through. The controls have to run the whole line as one machine.
The controls are specified for the line as a whole. The panel itself goes to a UL listed panel shop. That phrase has a specific meaning. A UL listed panel shop is a shop that UL has authorized, after training and with a qualified technical representative on staff. The shop can build industrial control panels to the UL 508A standard and apply the UL Mark to them. Follow-up factory inspections confirm that the shop keeps doing so. You should ask any vendor whether the panel in their quote carries that mark.
Scope, Shipping, and What Happens After Startup
Design, controls, fabrication, coordination, shipping, and installation are the stages of the job. Three parts of the job are worth explaining in detail.
- What to send before anyone quotes. What the material is, how much of it, what the building will allow, and which existing equipment stays. Photographs and a floor plan are usually enough to start. Everything is built to order and quoted per job. So the price comes from this conversation.
- Shipping, which is a design constraint and not a last step. The federal width limit on the National Network is 102", or 8 feet 6". Anything wider moves as an oversize load on permits issued state by state. The width limit is why platforms and catwalks are fabricated in the shop in practical sections for shipping. It is also why the place where a long run is split is decided on the drawing, not on the loading dock.
- What happens after startup. We train plant maintenance crews in the maintenance procedures that are specific to each machine. We can also supervise or perform the more specialized procedures later. Replacement parts come from the same shop for the life of each machine. The same shop also provides repair, refurbishing, and belt replacement.
The guide on how to buy a conveyor covers what to ask for and which quotes to distrust.
Turn-Key vs. Buying a Conveyor System Piecemeal
The alternative to a turn-key system is to buy the pieces separately. For example, conveyors come from one supplier, screens from another, and structure from a steel fabricator. Controls come from an integrator, and installation comes from a local contractor. Buying the pieces separately is a valid way to build a plant, and for a small addition it is often the right way. As the conveyor system gets larger, what changes is who is responsible for the interfaces between the pieces.
Nothing in a processing line works alone. The discharge height of one machine is the infeed height of the next. The chute between them belongs to neither purchase order until someone assigns it to one of them.
| Factor | One turn-key vendor | Several vendors, bought separately |
|---|---|---|
| Layout | One party lays out the whole line and is responsible for the elevations | Each supplier designs to its own scope. The buyer has to reconcile the designs |
| Chutework and transitions | Drawn as part of the conveyor system, for the machines they sit between | Belong to no purchase order unless a scope names them |
| Drawings | One set, checked against each other before anything is cut | Separate sets on separate schedules. Conflicts appear later |
| Controls | One operating logic covering the whole line | Interlocks between different makers' machines still have to be specified by someone |
| Shipping | Loads designed and sequenced to match the install order | Separate shipments, separate arrival dates, separate unloading |
| Installation | A crew that already knows the conveyor system, on one schedule | Coordinated by the buyer or a general contractor across trades |
| When it does not run right | One number to call | Diagnosis first, then a conversation about whose part it is |
| Later changes and parts | Parts and later changes come from the shop that built it | Depends on what each supplier still stocks and still supports |
Remcon has worked in both roles, managing whole turn-key systems and supplying one part of somebody else's system. Either is workable. You should decide which one you are buying before steel is ordered. The reason is that interfaces are cheap to settle on a drawing and expensive to settle in a finished building.
How to Compare Turn-Key Firms on a Conveyor Plant
Every firm that will quote a conveyor-based plant calls itself turn-key. The word is not regulated. The scopes behind it are not the same size. Four questions let you compare the firms. You should ask them before the quotes come back, while the answers can still be compared side by side.
- Where does their turn-key stop? Get the boundary in writing. Ask whether the price includes the support structure, the platforms and guardrail, and the chutework between machines. Also ask whether it includes the control panel, the freight, and the erection. A quote that covers the machines and leaves the rest “by others” has a lower price, but it is not a turn-key quote. The difference appears later as change orders.
- What do they build, and what do they buy? A firm that claims to manufacture every machine in a modern materials recovery facility (MRF) is either enormous or is exaggerating. The useful answer is a specific one: here is what we fabricate, here is what we buy and integrate, and here is who makes it. Remcon fabricates conveyors and their related products (support structure, platforms and catwalks, chutework, bins, and hoppers) and names the manufacturer behind everything else.
- Whose crew erects it? A shop that fabricates but subcontracts erection is selling coordination, not accountability. Ask who employs the crew, how many of them there will be, and whether they have erected this equipment before. Remcon's crews work for the shop that designed and built the steel.
- What happens in year ten? The conveyor system outlives the project. Ask who trains the maintenance crew at startup. Ask where a replacement belt or pulley comes from after the job is closed out. Ask who to call for a later change to the line. Remcon: the same shop, for the life of the machine.
Track record is the fifth question and the hardest one to exaggerate. Remcon has been building this equipment since 1977. We have produced more than 1,500 complete systems, including more than 150 high-speed optical sorting conveyors.

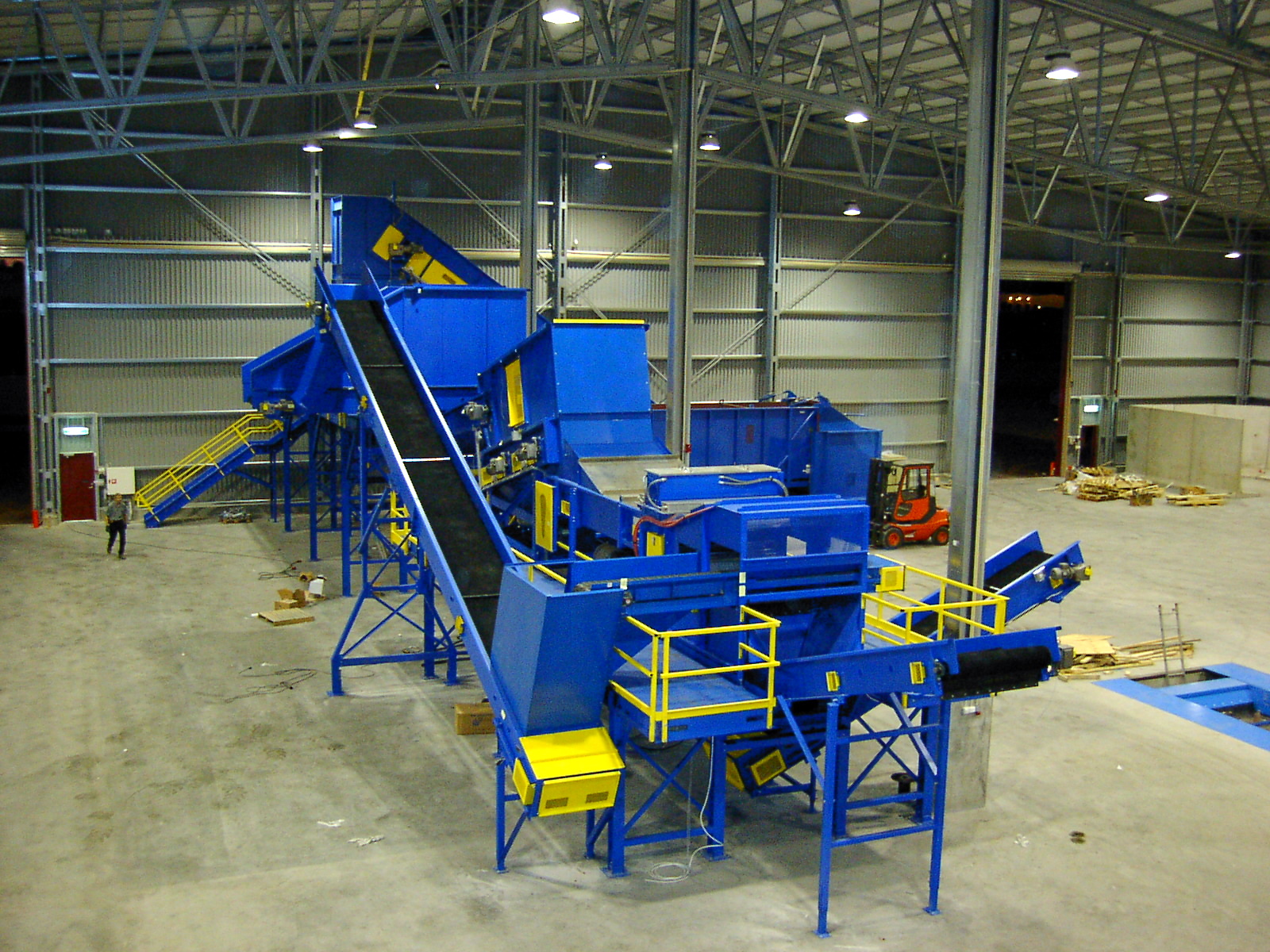

Turn-Key Conveyor Installation, Nationwide
A system is not finished when it ships. The crew that erects it works for the shop that designed and built it. The shop's own crew is the part of turn-key that is hardest to buy any other way.
There is one shop, at 2207 S. Lawson St. in Airway Heights, Washington, outside Spokane. Crews travel from there to the job. Distance from Spokane changes the travel and freight arrangements, not whether the work is done. Low overhead makes this possible. Crews go to almost anywhere in the United States and Canada. Remcon has also completed projects in Europe, Canada, Sweden, and Australia.
Crews have 2 to 4 people. That size has proven the most efficient use of time and resources. A small crew also means less disruption in plants that have to keep running while the work continues. If a changeover forces downtime, the shutdown is planned in advance, not discovered on site. On a retrofit across three facilities in two states, we installed around production wherever we could. We also scheduled the shutdowns needed to cut over from the old system. We will often ask about borrowing your forklift instead of renting one, to keep the installed cost low. However, the crew arrives fully equipped with the tools that the job needs.
Remcon has filled almost every role on an installation. One role is one crew member working alongside a plant maintenance crew on a belt replacement. Another role is supervision of an installation done with customer-supplied workers. Another role is the conveyor installer hired by a general contractor on a new building. Another role is full management of a turn-key recycling system installation. On new construction, the difference between the last two roles matters. The reason is that the general contractor holds the schedule and the conveyor scope has to fit inside it.
More on field work: installation services, including past projects, and repair, refurbishing, belt replacement, and system moves. To start a system, request a quote or call (509) 244-9439.
Turn-Key Conveyor System FAQ
What is a turn-key conveyor system?
A turn-key conveyor system is a complete material handling line. One provider delivers the line and hands it over ready to run. The line has all the conveyors, structures, equipment, and accessories that the application needs. One shop designs, fabricates, ships, and installs them. The point is single vendor accountability. Specifically, one party is responsible for the layout and the elevations. The same party is responsible for the chutework between machines, the control logic, the freight, and the erection. So the buyer does not have to reconcile suppliers. Remcon has produced more than 1,500 complete systems since 1977.
Does Remcon do turn-key conveyor installation outside the Northwest?
Yes. Remcon fabricates in Airway Heights, Washington, near Spokane, and ships and installs nationwide with its own crews. Distance from the shop changes the travel and freight arrangements, not whether the work is done. Low overhead and crews of 2 to 4 make travel practical. Crews go to almost anywhere in the United States and Canada. Freight is designed into the job from the start. Anything wider than 102" moves on state-by-state oversize permits. The width limit decides where a long run is split for shipping.
Does Remcon build every piece of the conveyor system itself?
No, and no honest turn-key vendor does. Remcon fabricates conveyors and their related products, including support structure, platforms, chutework, bins, and hoppers, in its own shop. Remcon buys specialized equipment from the manufacturers that build it best and integrates it into the conveyor system. This equipment is shredders, walking floors, modular roller conveyors, disc screens, and vibratory screens and feeders. The specialized equipment also includes the magnet in an overhead separator, the rotor in an eddy current separator, and the blower on a pneumatic run. Remcon has occasionally built screening equipment itself, including glass breakers and roller screens. Building screening equipment itself is the exception, not how these machines are normally supplied. Ask any vendor which equipment they build and which equipment they buy on your job. The accountability should not be split. One party is still responsible for the layout, the interfaces, and the result.
Can Remcon work under a general contractor on new plant construction?
Yes. On new construction, the general contractor holding the building has hired Remcon as the conveyor installer. Remcon prefers direct contact with the other contractors and equipment suppliers, so that information moves both ways and problems are found at the drawing stage. Remcon has also managed whole turn-key recycling systems without a general contractor. Either arrangement works. What matters is that the conveyor scope, the chutework, and the interfaces to other manufacturers' machines are named in writing before steel is ordered.
How long does a turn-key conveyor project take?
There is no catalog answer, because everything is built to order and quoted per job. The schedule depends on the size of the conveyor system and how much of it comes from other manufacturers. The schedule also depends on whether the plant has to keep running during installation. This last factor is usually the constraint that sets the shutdown windows. Tell us the material, the volume, and the building. We will give you a schedule and a price.
